SEALR Bridge Construction – Captured by Aylesbury Drone

As most of Aylesbury winds down for the Christmas break in 2025, one of the town’s most significant infrastructure milestones is quietly taking shape. From 25–28 December, engineers are undertaking the critical bridge installation for the South East Aylesbury Link Road (SEALR). This is a key structure that will eventually transform how traffic moves around the south and east of the town. While many residents are celebrating at home, this four‑day construction window marks a pivotal moment in a project designed to ease congestion, improve connectivity, and support Aylesbury’s long‑term growth.

This will mean that the usual Aylesbury to London Chiltern Rail link will be suspended over the build.

Sky Eye Imagery is on site throughout the operation, capturing the build from above as the new bridge is lifted, positioned, and secured into place. This rare Christmas engineering effort offers a unique opportunity to document the precision, scale, and coordination behind one of Buckinghamshire’s most important transport upgrades.

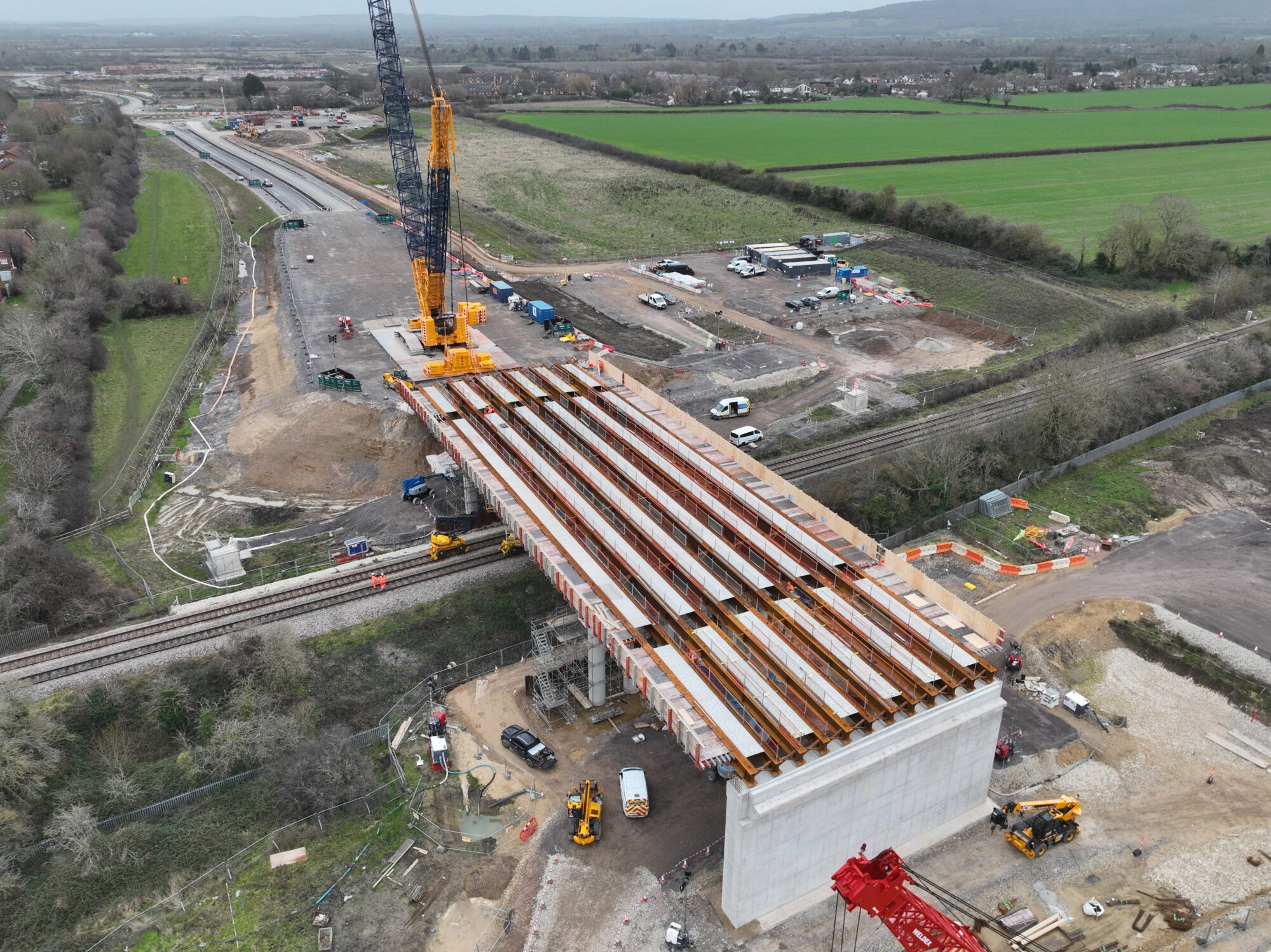

SEALR Bridge Construction Rolling Update – 28 Dec 25 – 1400hrs

The SEALR western spans have been put in place.  There is a lot more work in 2026 to complete the bridge.
The SEALR western spans have been put in place. There is a lot more work in 2026 to complete the bridge.

SEALR Bridge Construction Rolling Update – 27 Dec 25 – 1400hrs

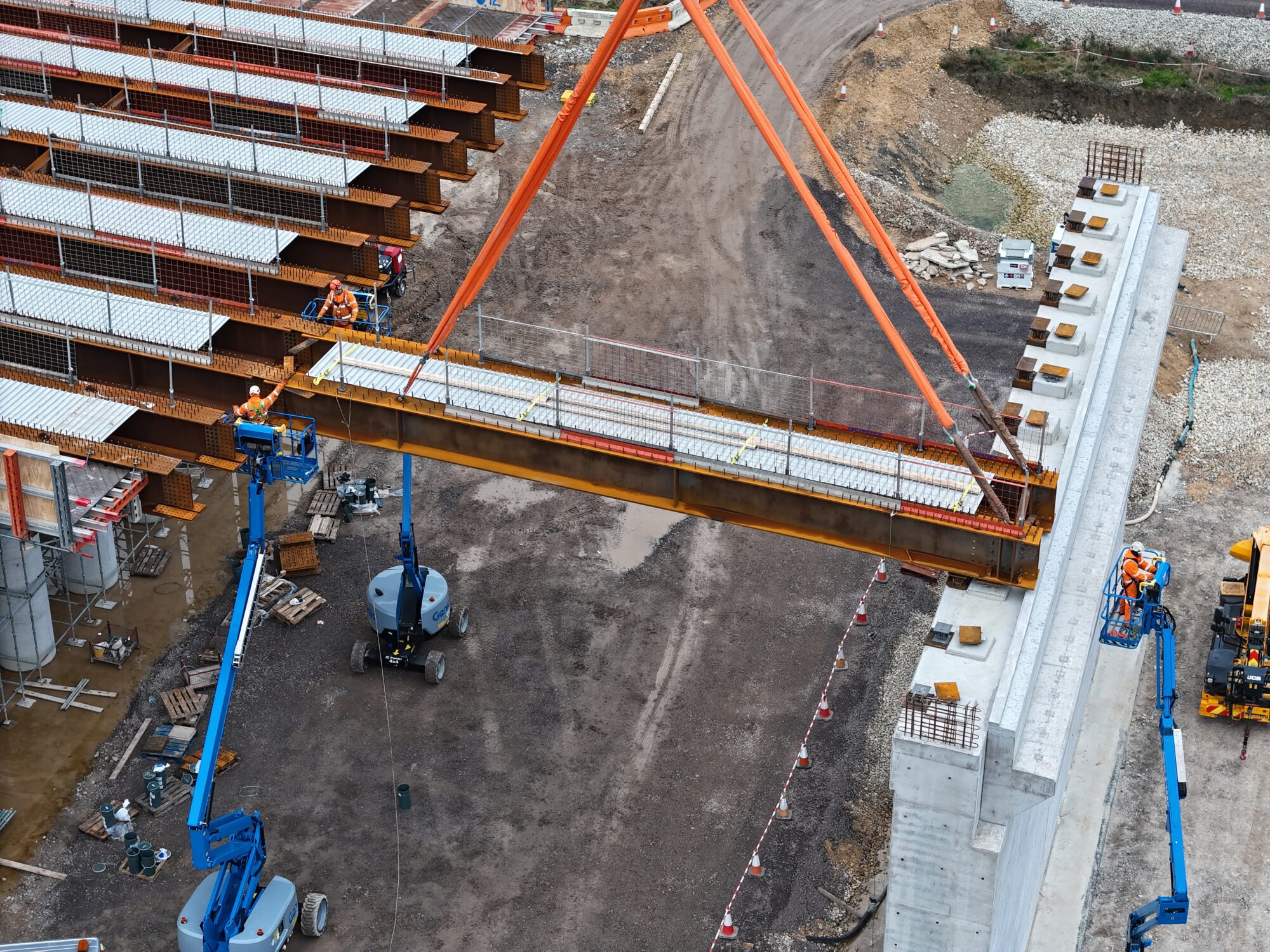

Frist western span of the SEALR bridge was moved into position with great skill.
Frist western span of the SEALR bridge was moved into position with great skill.

SEALR Bridge Construction Rolling Update – 27 Dec 25 – 0900hrs

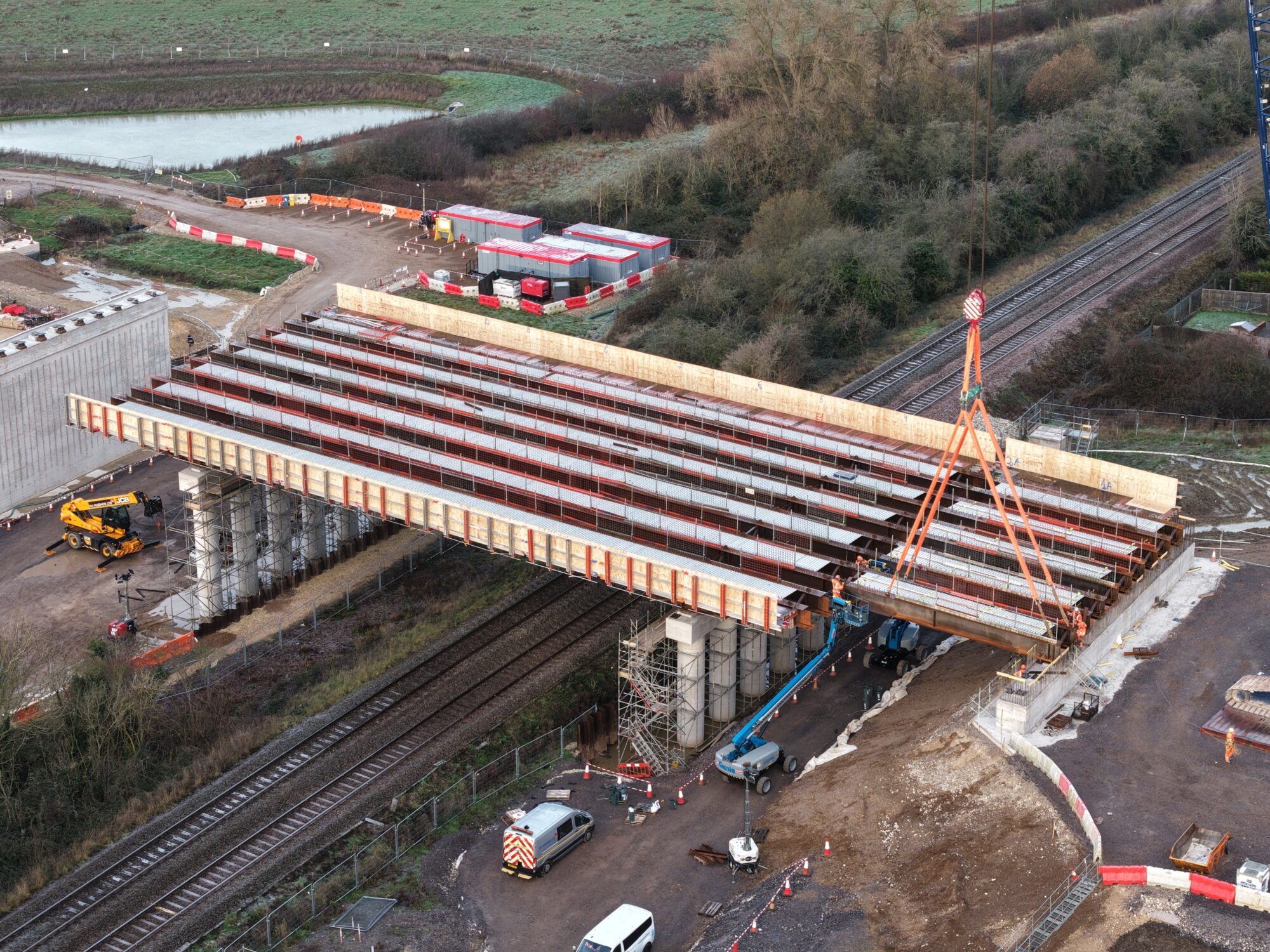

At 0900 this morning the beams on the eastern side of the SEALR bridge construction were being moved into place.
At 0900 this morning the beams on the eastern side of the SEALR bridge construction were being moved into place.
Drone timelapse of a smaller beam being placed on the east side of the SEALR bridge that is under construction.

SEALR Bridge Construction Rolling Update – 27 Dec 25 – 0200hrs

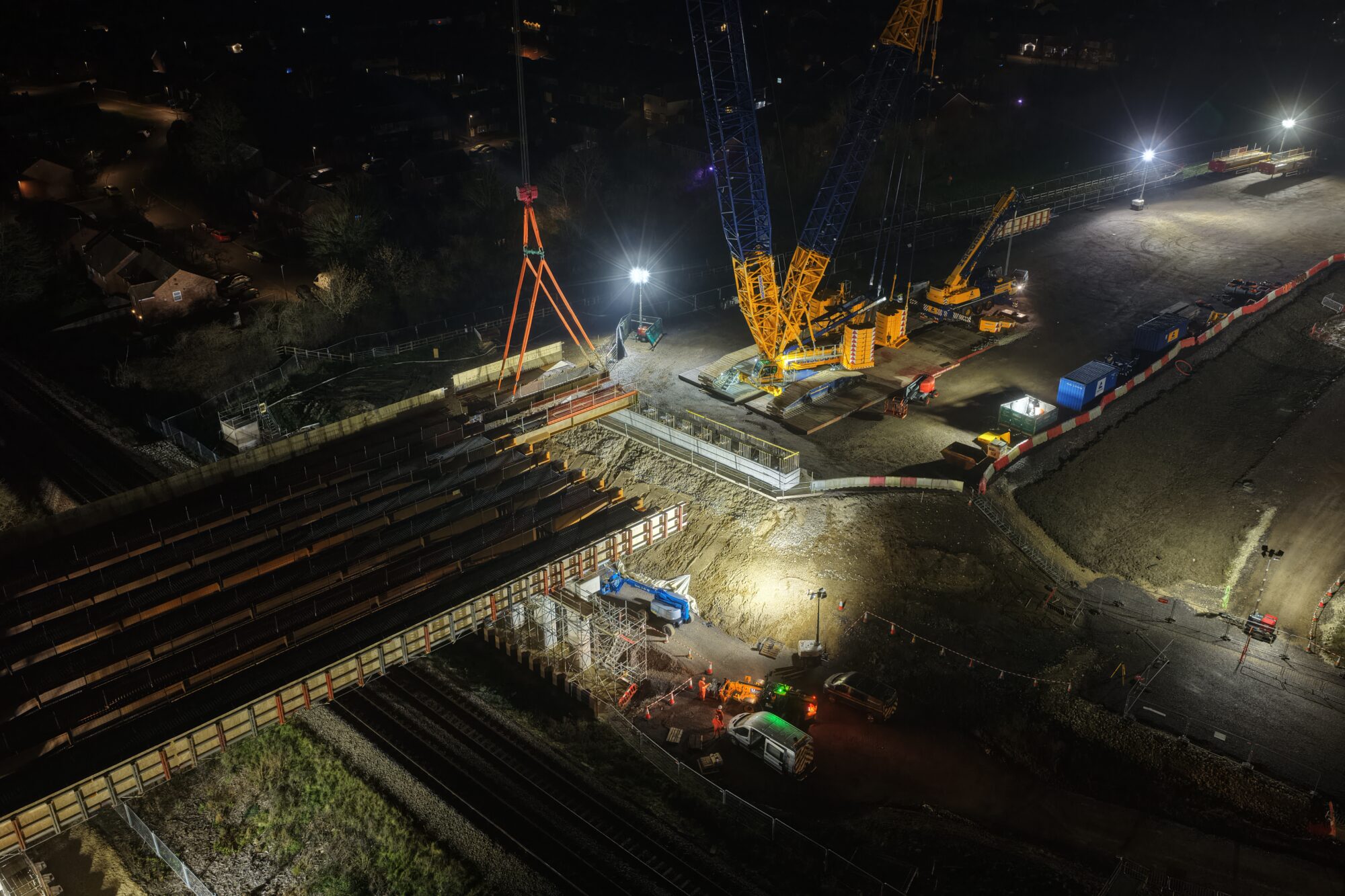

The shorter metal spans over the eastern end of the SEALR railway bridge are being moved into position.
The shorter metal spans over the eastern end of the SEALR railway bridge are being moved into position.
The shorter metal spans over the eastern end of the SEALR railway bridge are being moved into position.
The shorter metal spans over the eastern end of the SEALR railway bridge are being moved into position.

SEALR Bridge Construction Rolling Update – 26 Dec 25 – 1800hrs

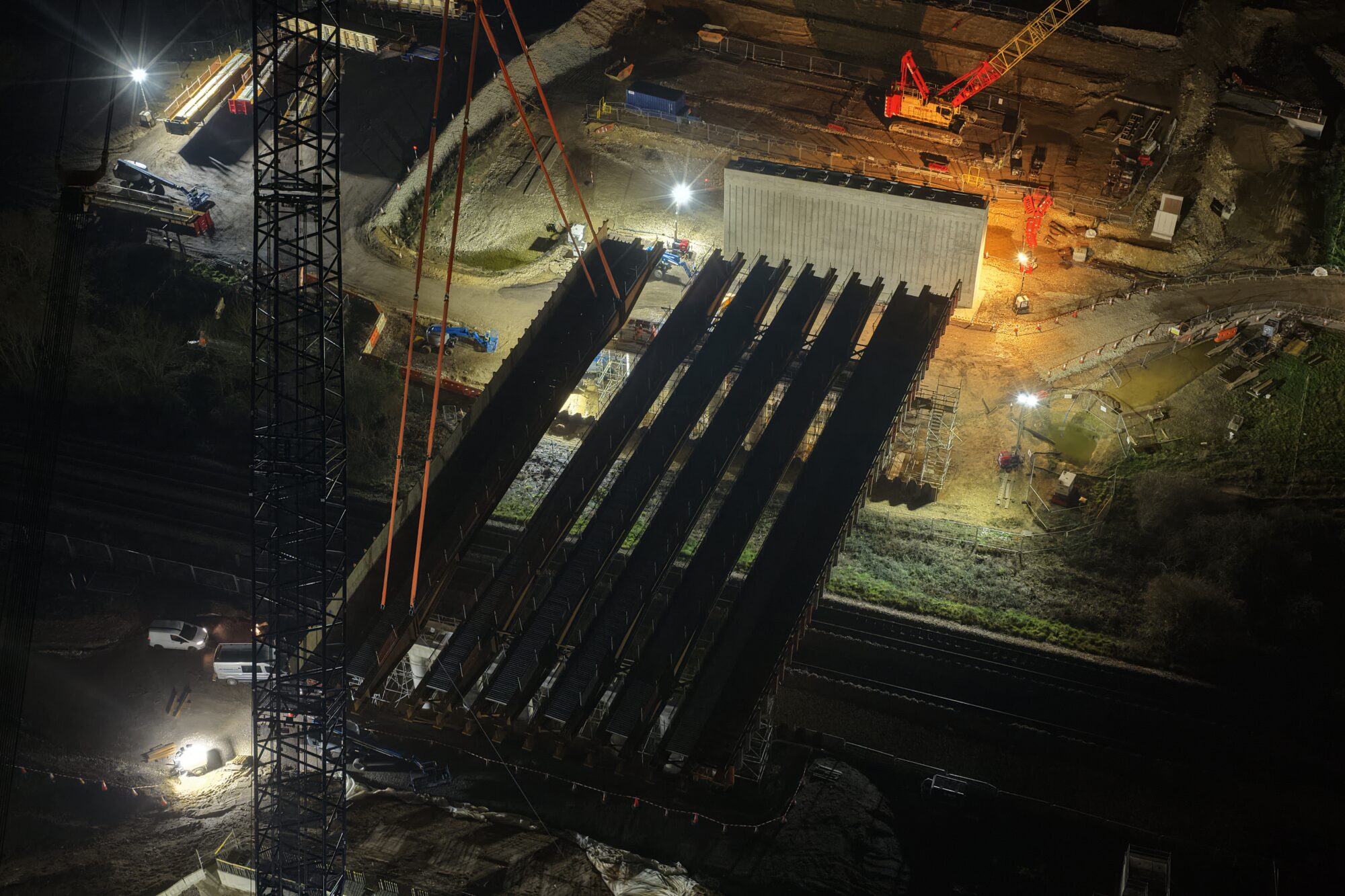

the 6th and final large SEALR bridge beam is lowered into position.
the 6th and final large SEALR bridge beam is lowered into position.
Drone video clip of the 6th SEALR bridge span being installed

SEALR Bridge Construction Rolling Update – 26 Dec 25 – 1500hrs

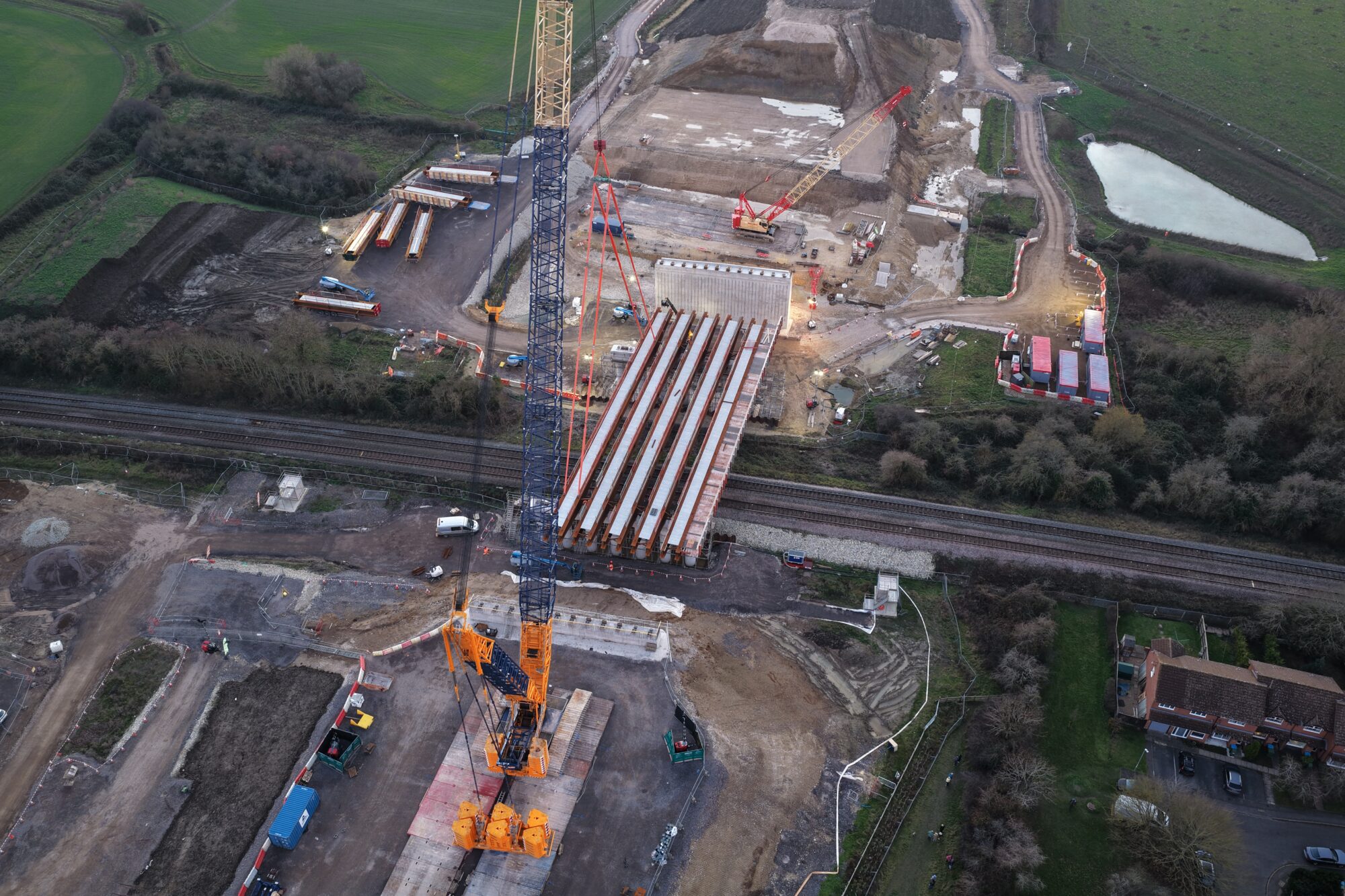

By about 1600 the final span was added and is being secured down.

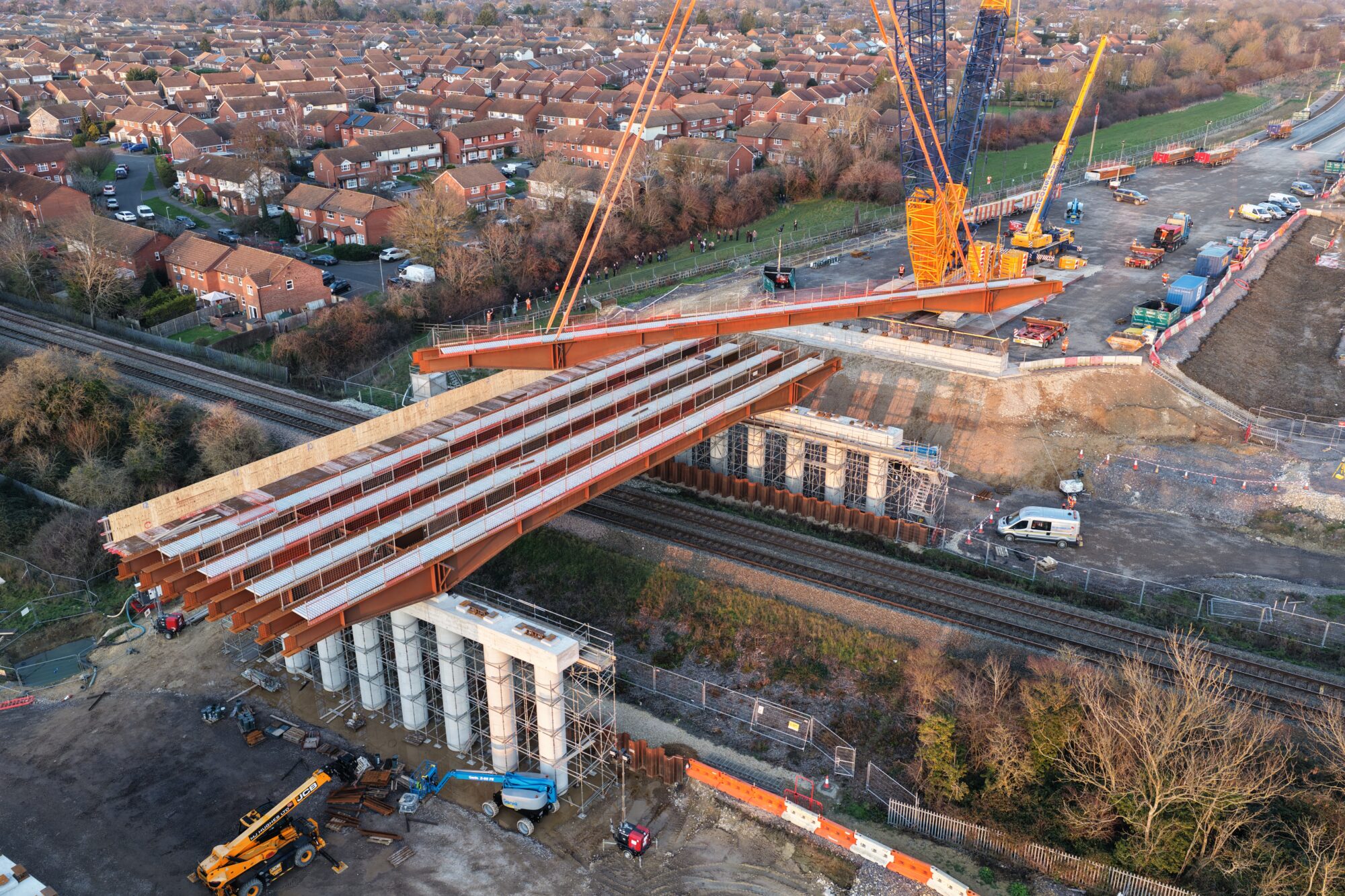

By about 1600 the 5th span was added and is being secured down.
the 5th SEALR beam is being added to the 4 that have already been secured to the SEALR railway bridge.
the 5th SEALR beam is being added to the 4 that have already been secured to the SEALR railway bridge.

SEALR Bridge Construction Rolling Update – 26 Dec 25 – 1030hrs

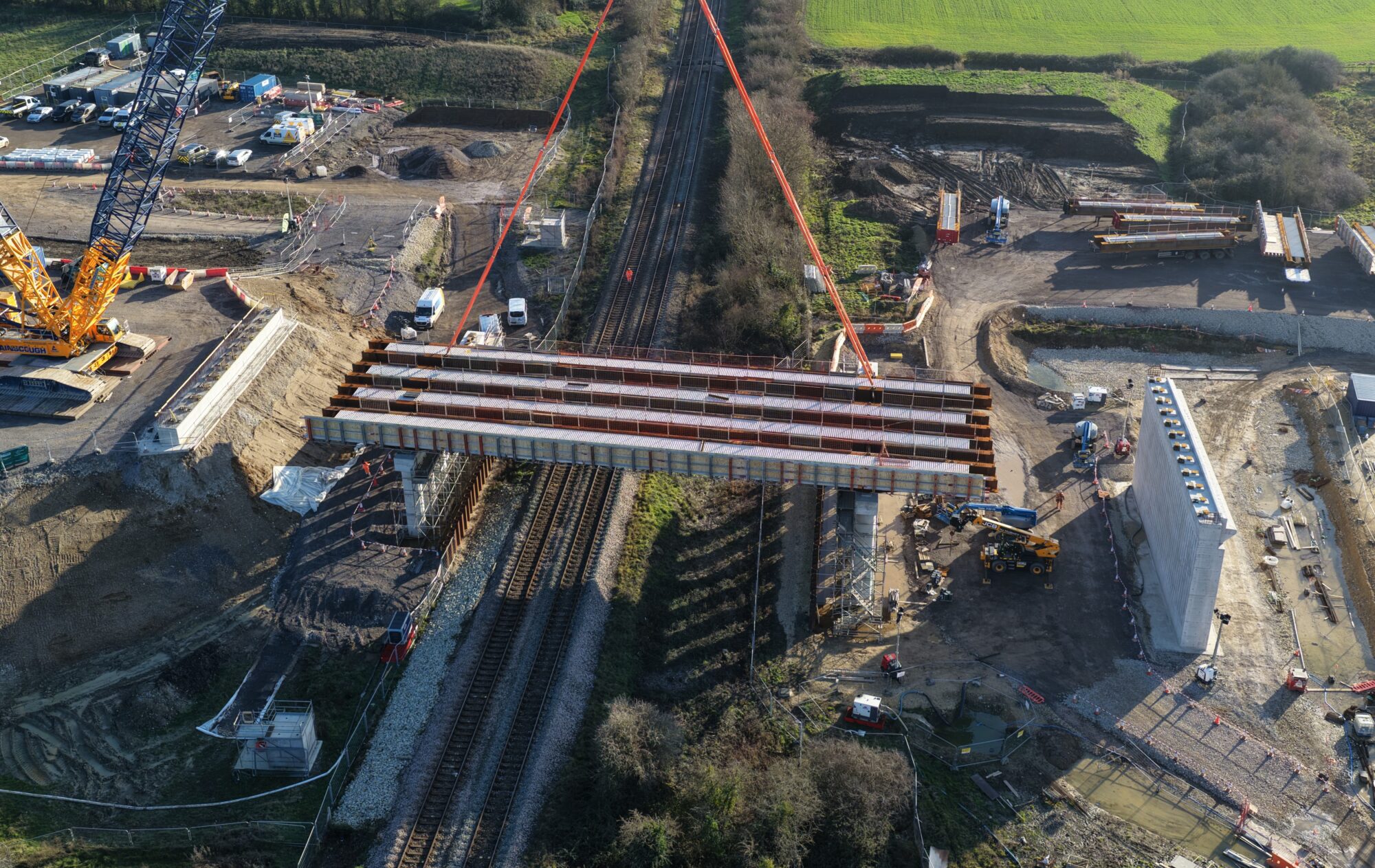

Four pans installed on the SEALR bridge by Boxing Day Morning.
Four pans installed on the SEALR bridge by Boxing Day Morning.

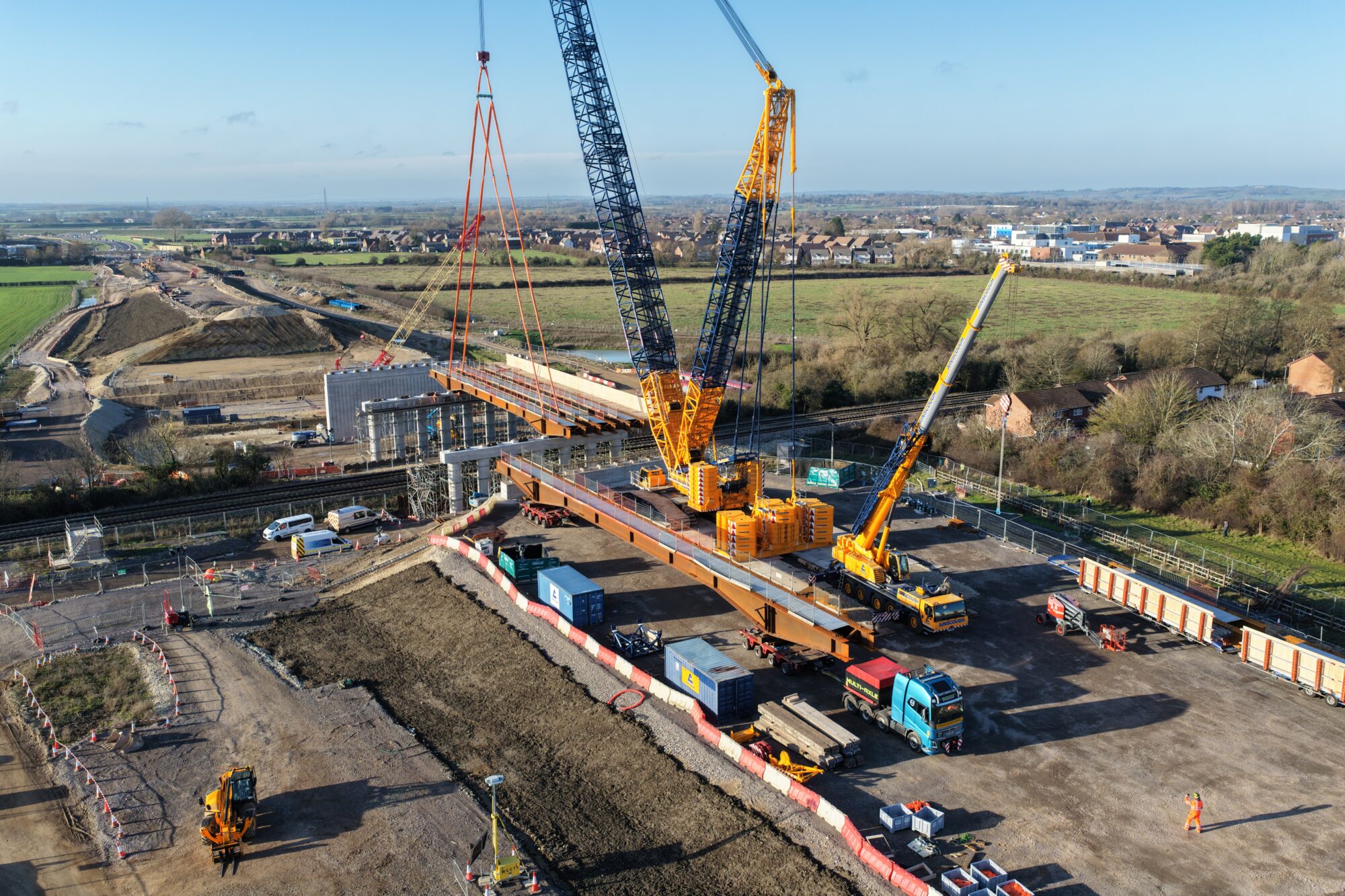

SEALR Three Spans Installed and Number Four Waiting
SEALR now has three spans installed with a fourth ready to go.

SEALR Bridge Construction Rolling Update – 26 Dec 25 – 0530hrs

The third main span on the SEALR railway bridge is being moved next to the previous two that were placed from 1830 on Christmas DAy.
The third main span on the SEALR railway bridge is being moved next to the previous two that were placed from 1830 on Christmas DAy.

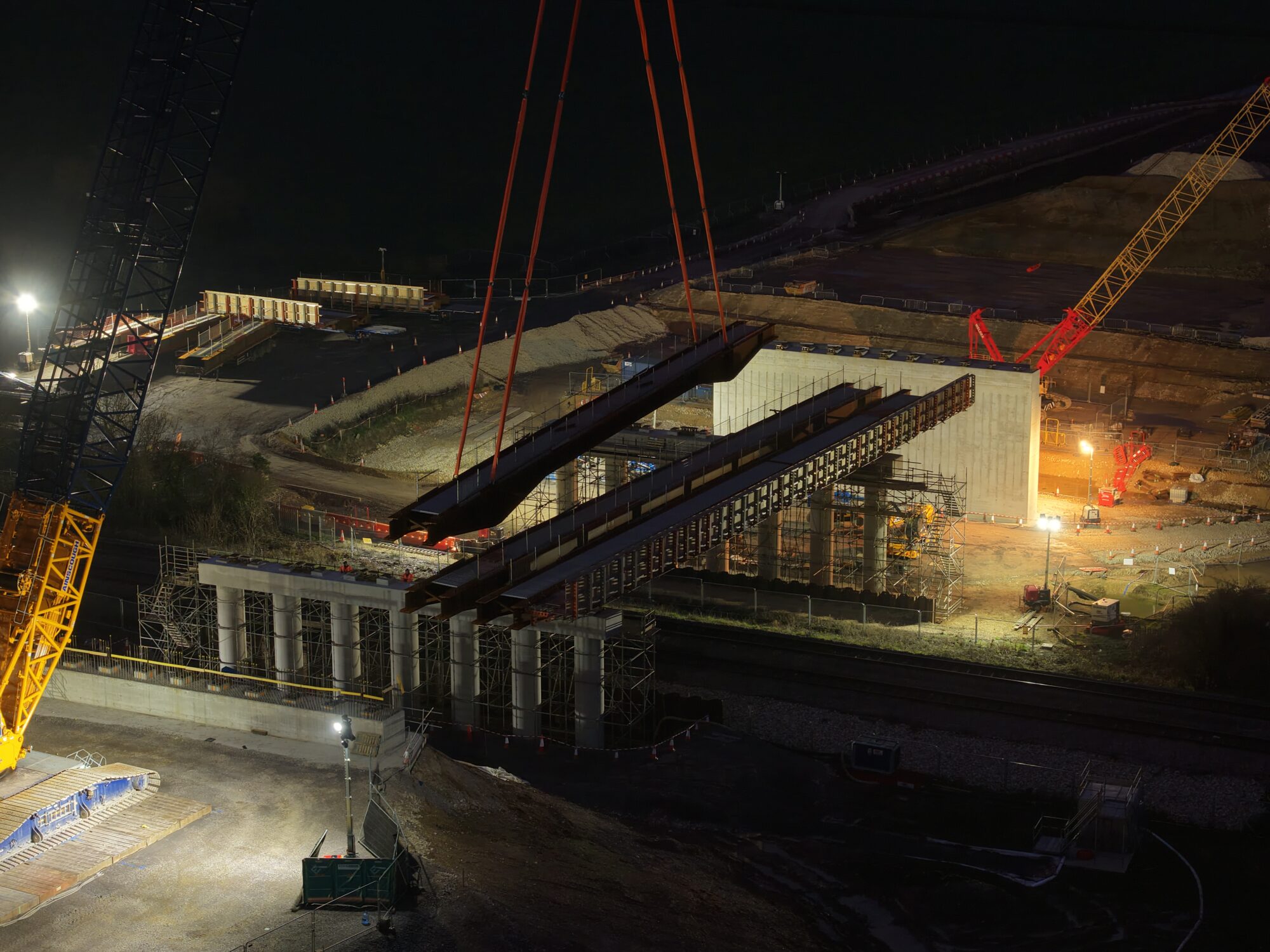

Enlarged. The third main span on the SEALR railway bridge is being moved next to the previous two that were placed from 1830 on Christmas DAy.
Enlarged. The third main span on the SEALR railway bridge is being moved next to the previous two that were placed from 1830 on Christmas Day.
Preparations are underway to secure the third span to the crawler crane before transportation to the SEALR bridge supports.

SEALR Bridge Construction Rolling Update – 26 Dec 25 – 0100hrs

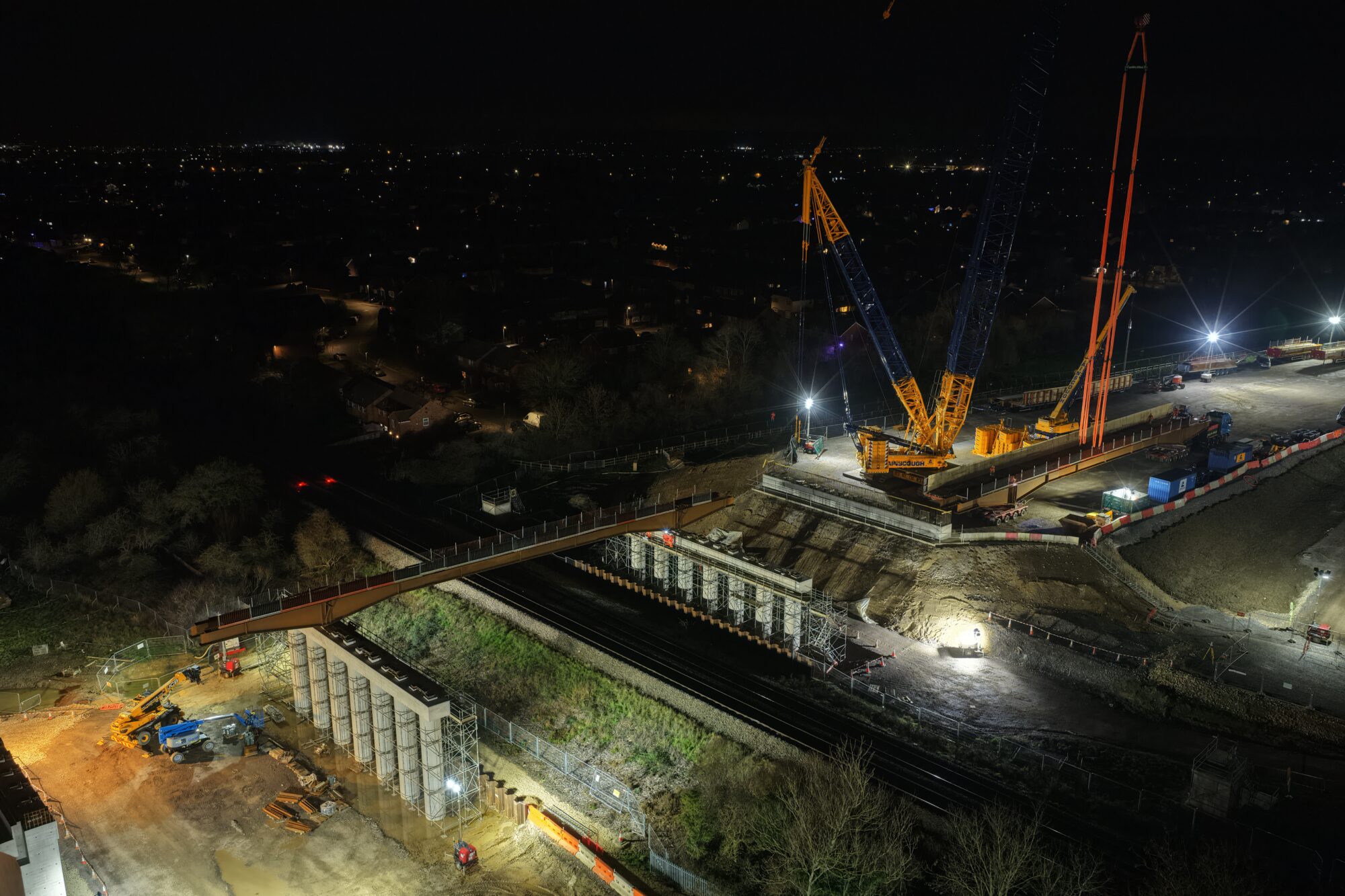

SEALR first span is in place and being secured. The second span can be see on the right hand side of the image.
SEALR first span is in place and being secured. The second span can be see on the right hand side of the image.

SEALR Bridge Construction Rolling Update – 25 Dec 25 – 2130hrs

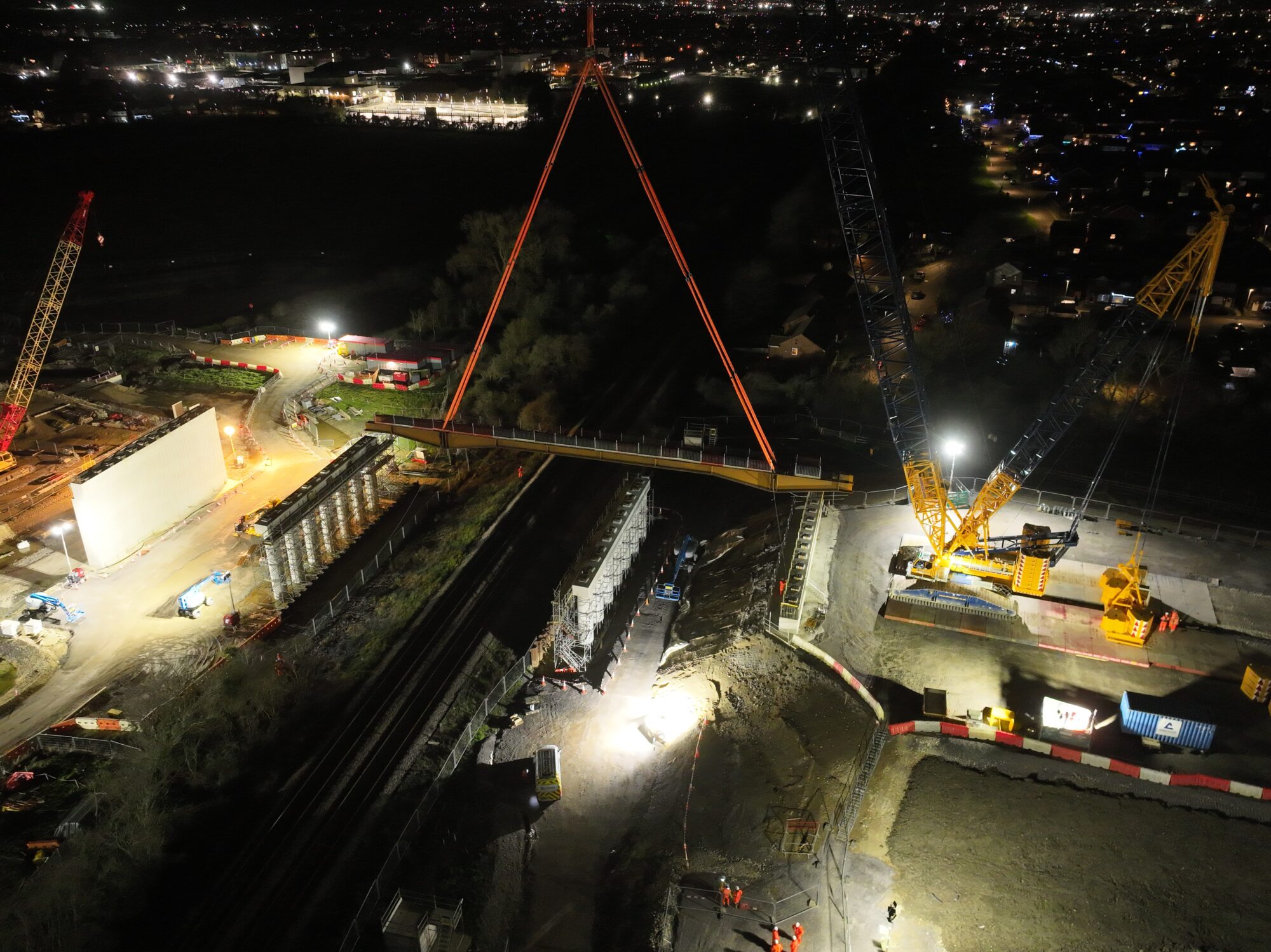

The first steel beam for the SEALR bridge in Aylesbury is being moved into position.
The first steel beam for the SEALR bridge in Aylesbury is being moved into position.

Guides for the placement of the SEALR bridge beam
Guides for the placement of the SEALR bridge beam

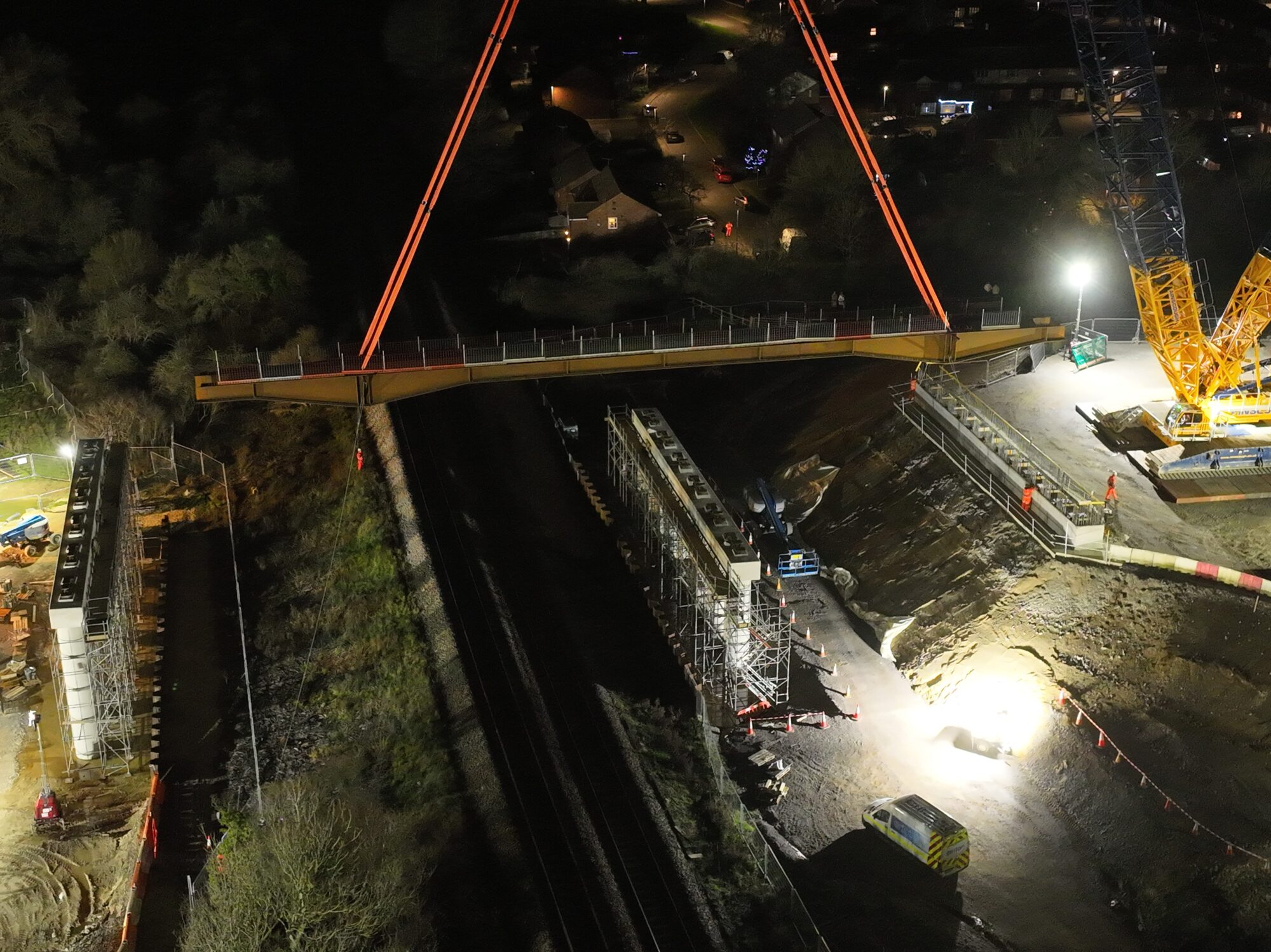

First beam of the SEALR bridge is being placed into position.
First beam of the SEALR bridge is being placed into position.

SEALR Bridge Construction Rolling Update – 25 Dec 25 – 1830hrs

Attachments have been placed onto the first beam
Attachments have been placed onto the first beam

SEALR Bridge Construction Rolling Update – 25 Dec 25 – 1000hrs

Christmas 2025 SEALR Crane
Christmas 2025 SEALR Crane

SEALR Bridge Construction Rolling Update – 25 Dec 25 – 0330hrs

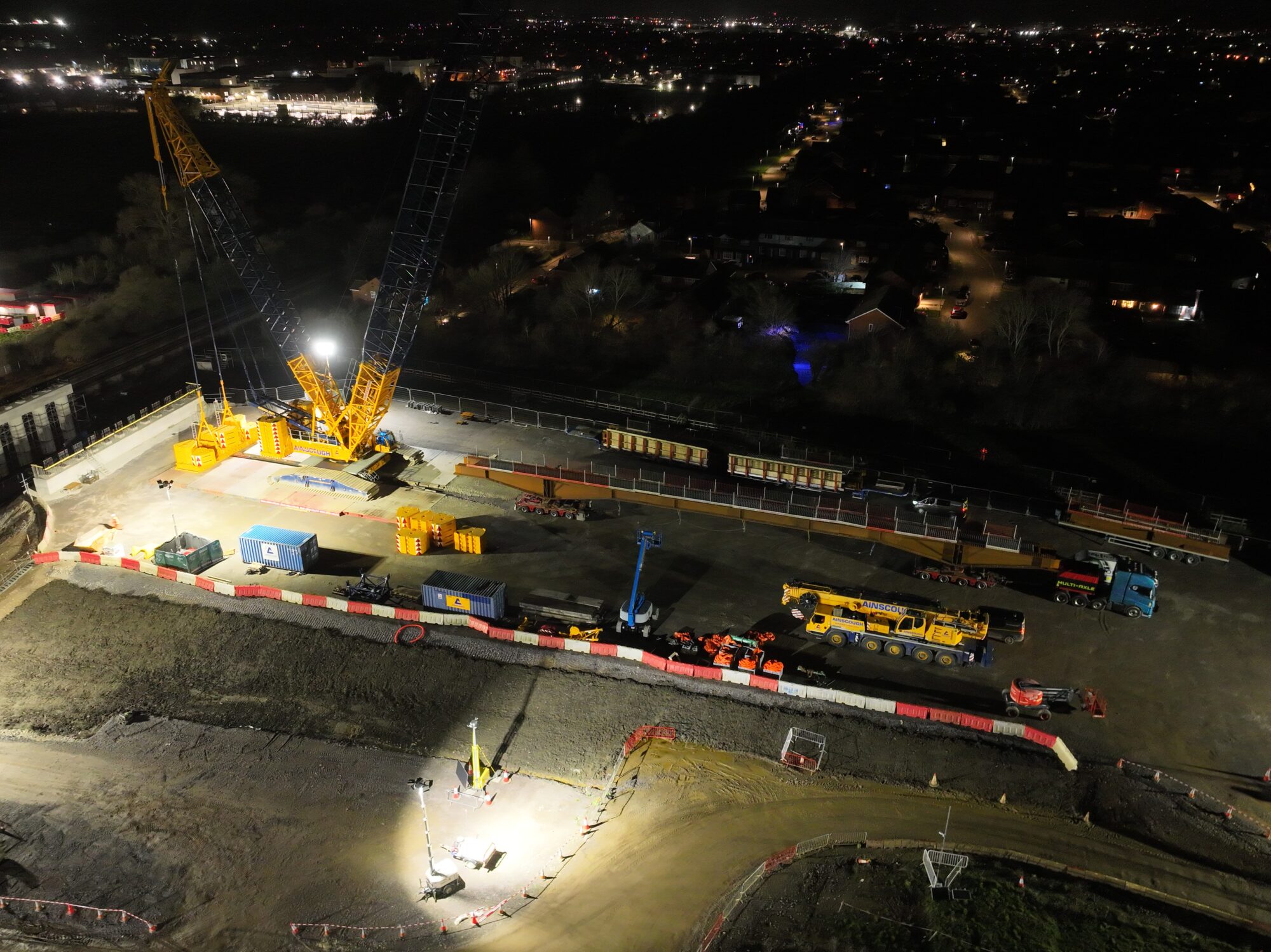

South view of the SEALR Bridge Construction Crane and Steel Cross Beam.
South view of the SEALR Bridge Construction Crane and Steel Beam.

SEALR Bridge Construction Rolling Update – 25 Dec 25 – 0000hrs

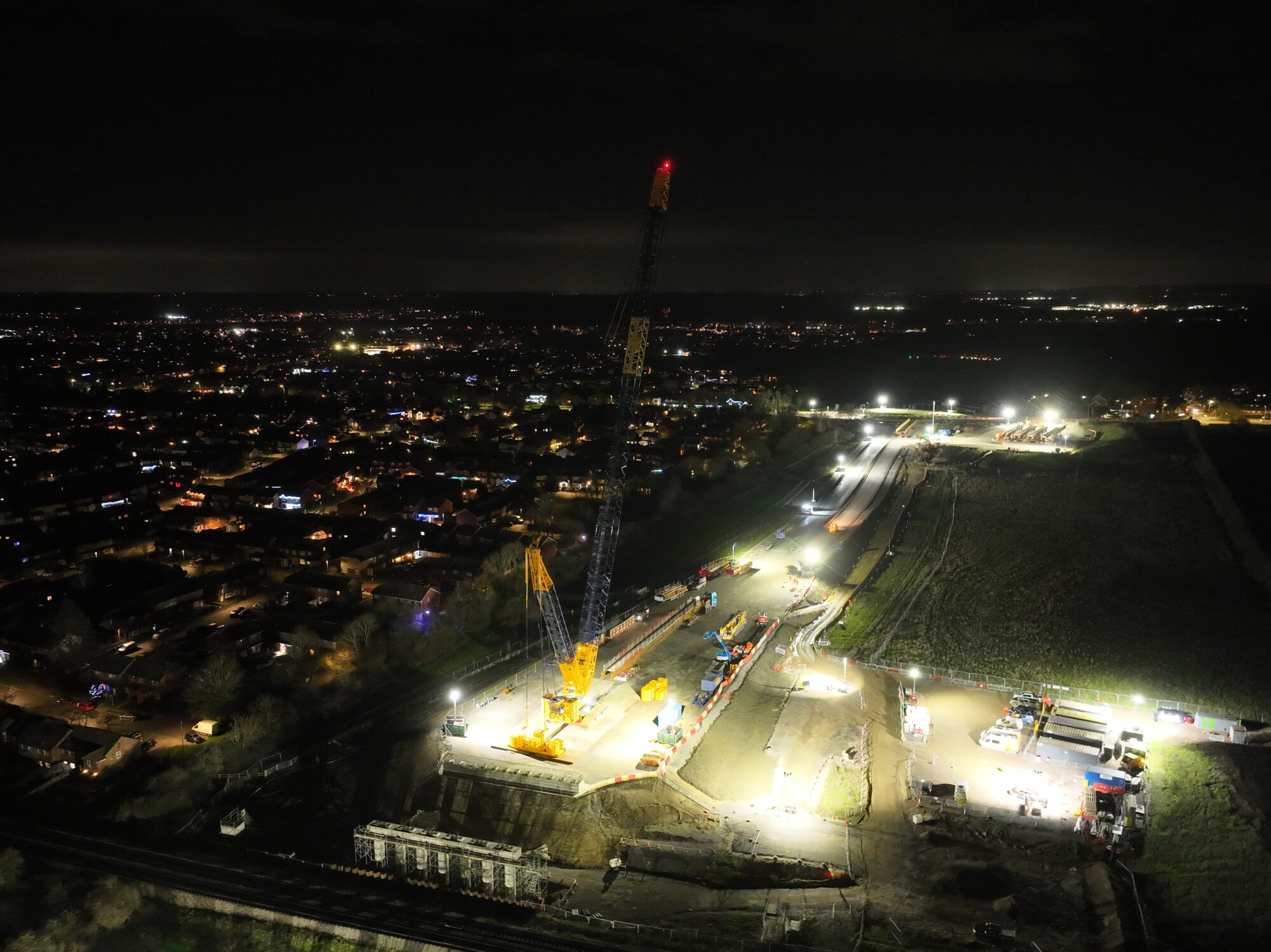

At 0030hrs, the eastern end of the SEALR construction site is lit up for the bridge construction works.
At 0030hrs, the eastern end of the SEALR construction site is lit up for the bridge construction works.
Steel Beam at The Foot Of The Crane when the wind speed is low enough to make lifting safe.
Steel Beam at The Foot Of The Crane.

SEALR Bridge Construction Rolling Update – 22 Dec 25

Drone Pivot View of SEALR Bridge Constructing Crane, south of Aylesbury, Buckinghamshire

By the 22 December 25 one of the largest cranes in Europe was in position on the eastern side of the Aylesbury to London railway line.

Close drone picot view of the piles and supports for the SEALR bridge installation.

The reason for the very large crane is the requirement to lift extremely heavy metal beams that will be placed across the railway tracks.

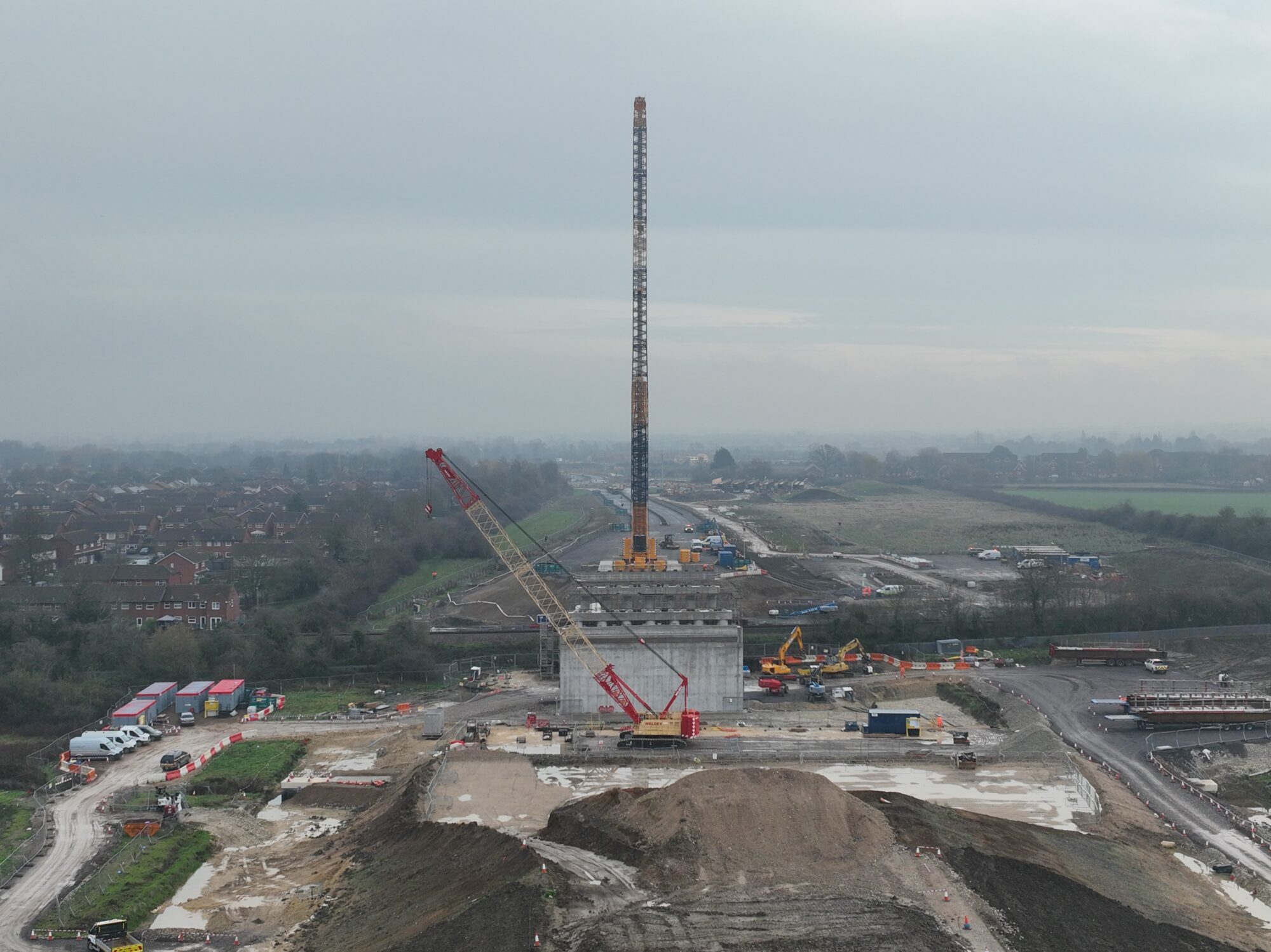

Striking comparison between the SEALR Bridge Construction Crane and Regular Crane
Striking comparison between the SEALR Bridge Construction Crane and Regular Crane

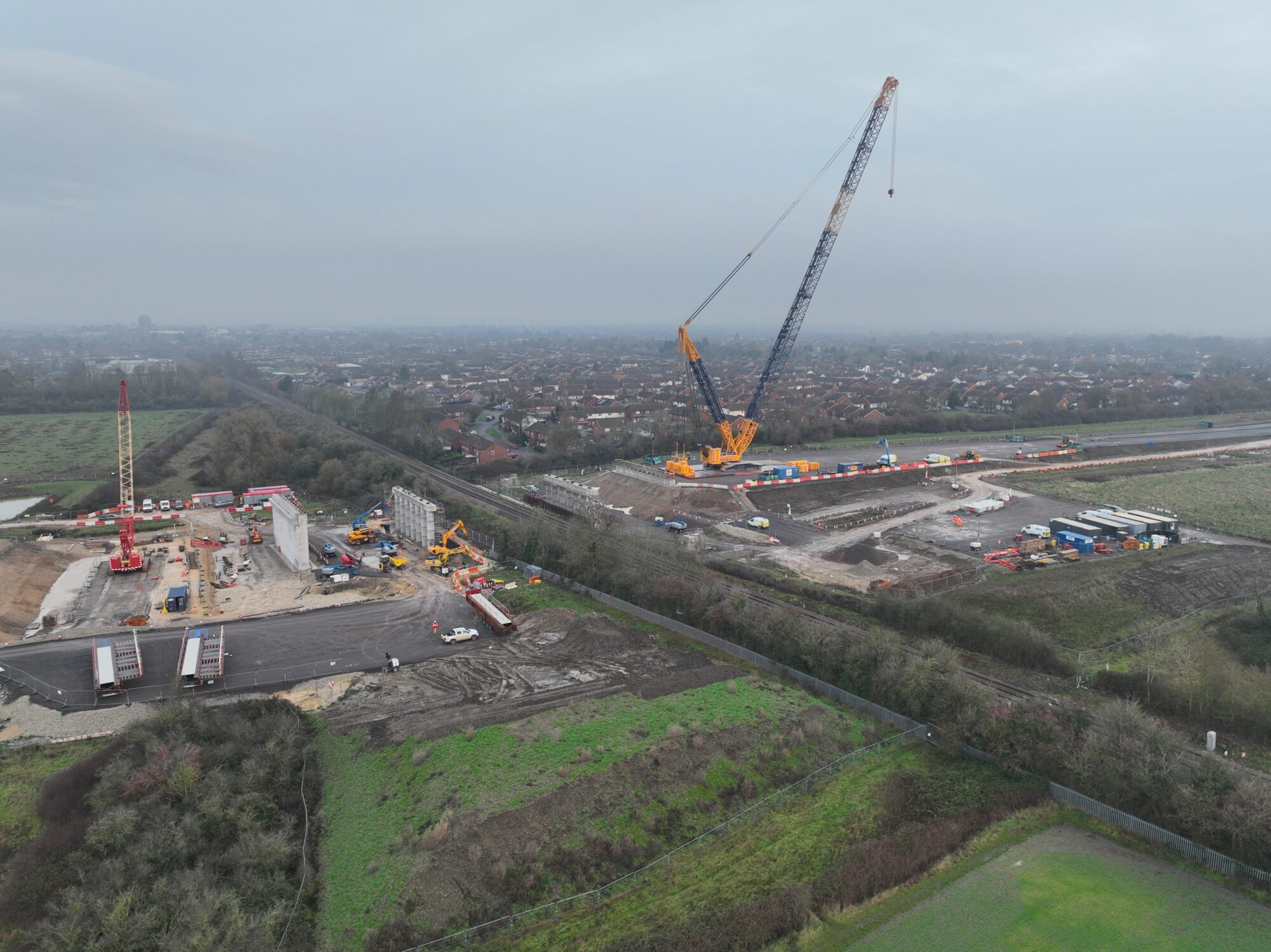

SEALR Bridge Construction Crane in Position for construction over Christmas 2025
SEALR Bridge Construction Crane in Position for construction over Christmas 2025
Drone Photograph of SEALR Bridge Supports
Drone Photograph of SEALR Bridge Supports. The heavy metal beams will be placed across the divide.

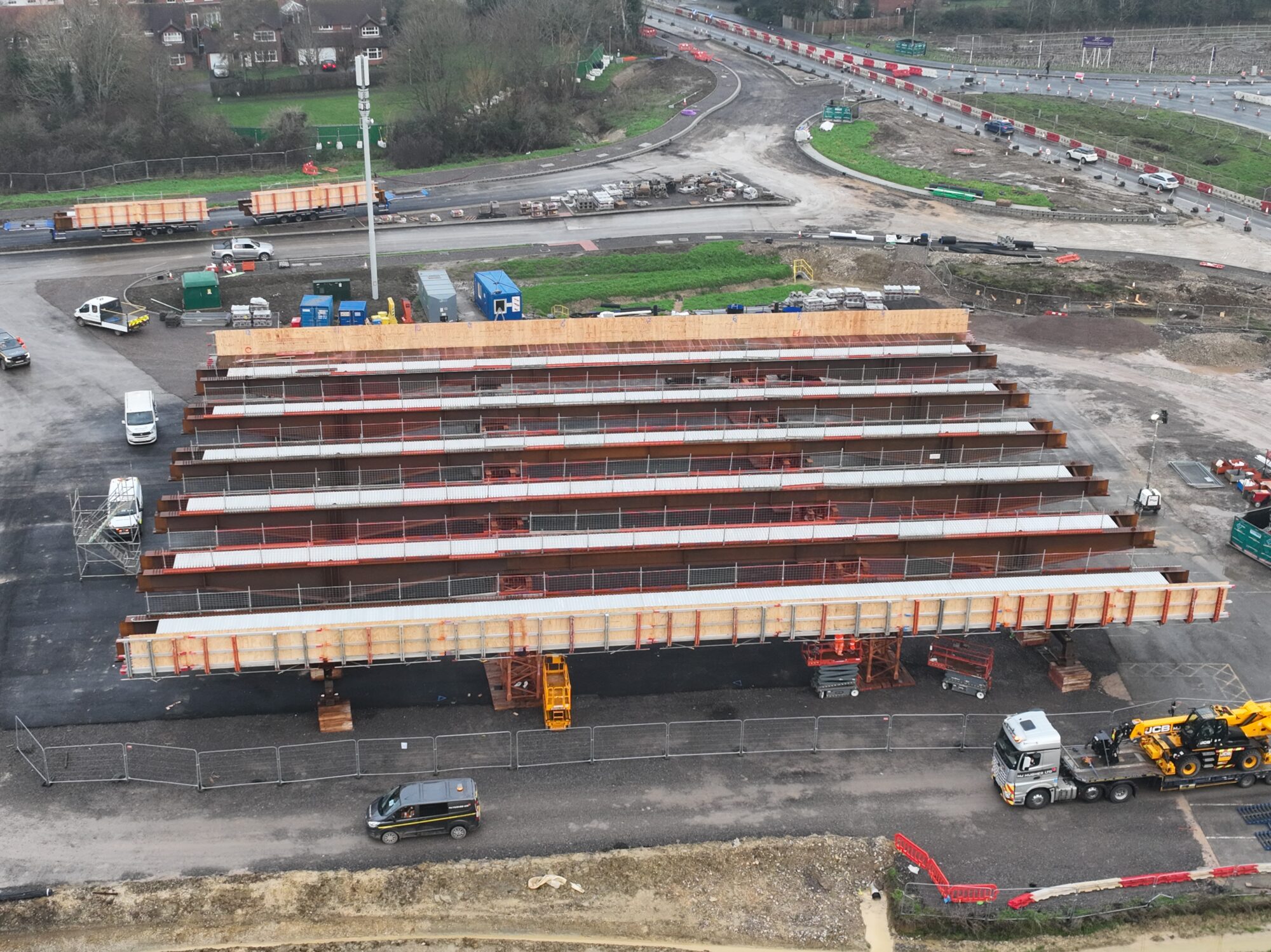

Large Steel SEALR Bridge Beams
Large Steel SEALR Bridge Beams

Low Angle View Of SEALR Construction Site
Low Angle View Of SEALR Construction Site
